Capital · industry pre-position
What it costs to stand up — and what it costs to wait
Two different checks. The field is a mid-hundreds-of-millions campaign. Pre-positioning for offtakers is a low-tens to ~$90 M decision. Missing the first clean paste lots is the expensive error.
Low field
$208 M
Base field
$353 M
High field
$606 M

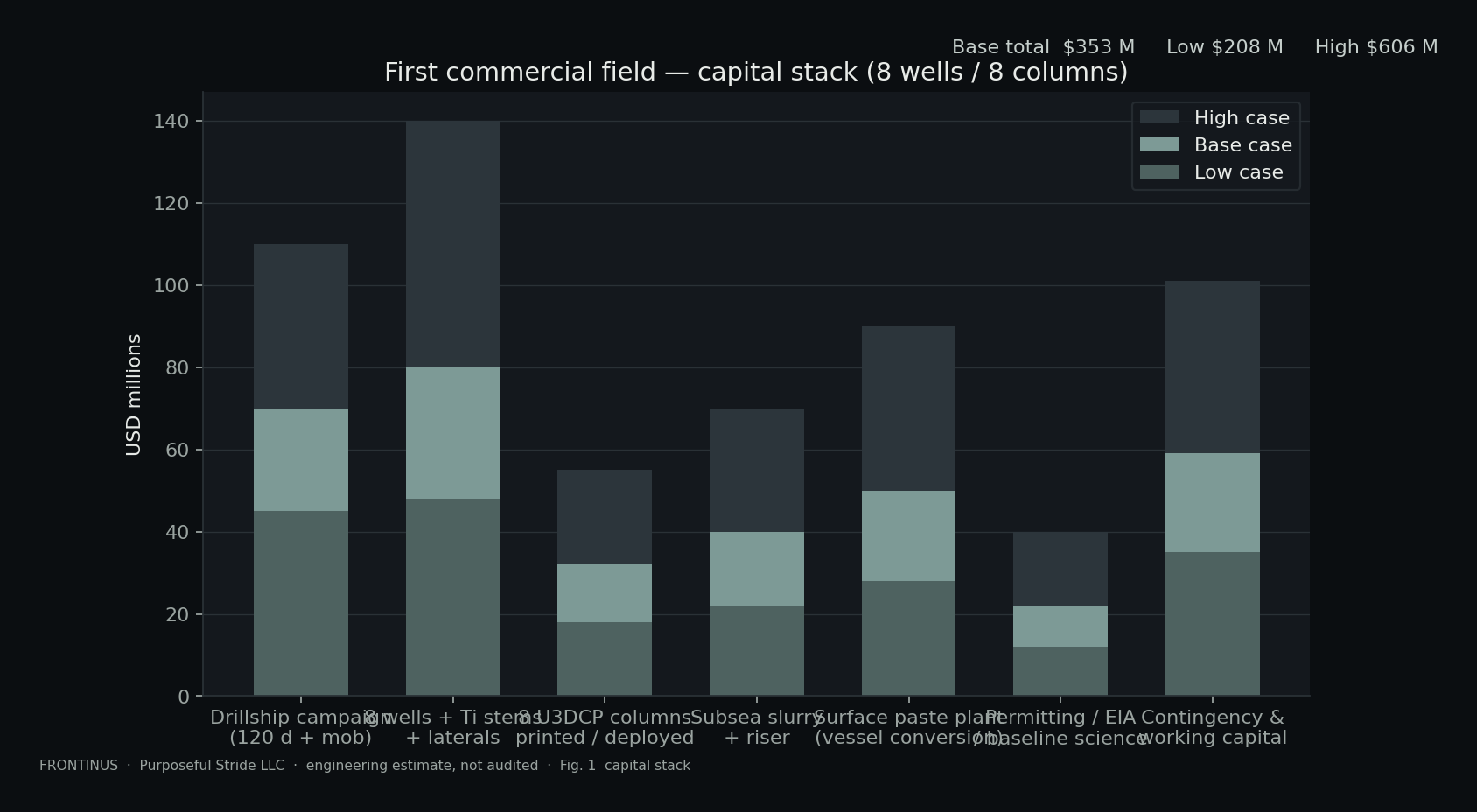

First-field stack (USD millions)
| Line | Low | Base | High |
|---|---|---|---|
| Drillship campaign (120 d + mob) | 45 | 70 | 110 |
| 8 wells + Ti stems + laterals | 48 | 80 | 140 |
| 8 U3DCP columns printed / deployed | 18 | 32 | 55 |
| Subsea slurry + riser | 22 | 40 | 70 |
| Surface paste plant (vessel conversion) | 28 | 50 | 90 |
| Permitting / EIA / baseline science | 12 | 22 | 40 |
| Contingency & working capital | 35 | 59 | 101 |
| Total | 208 | 353 | 606 |

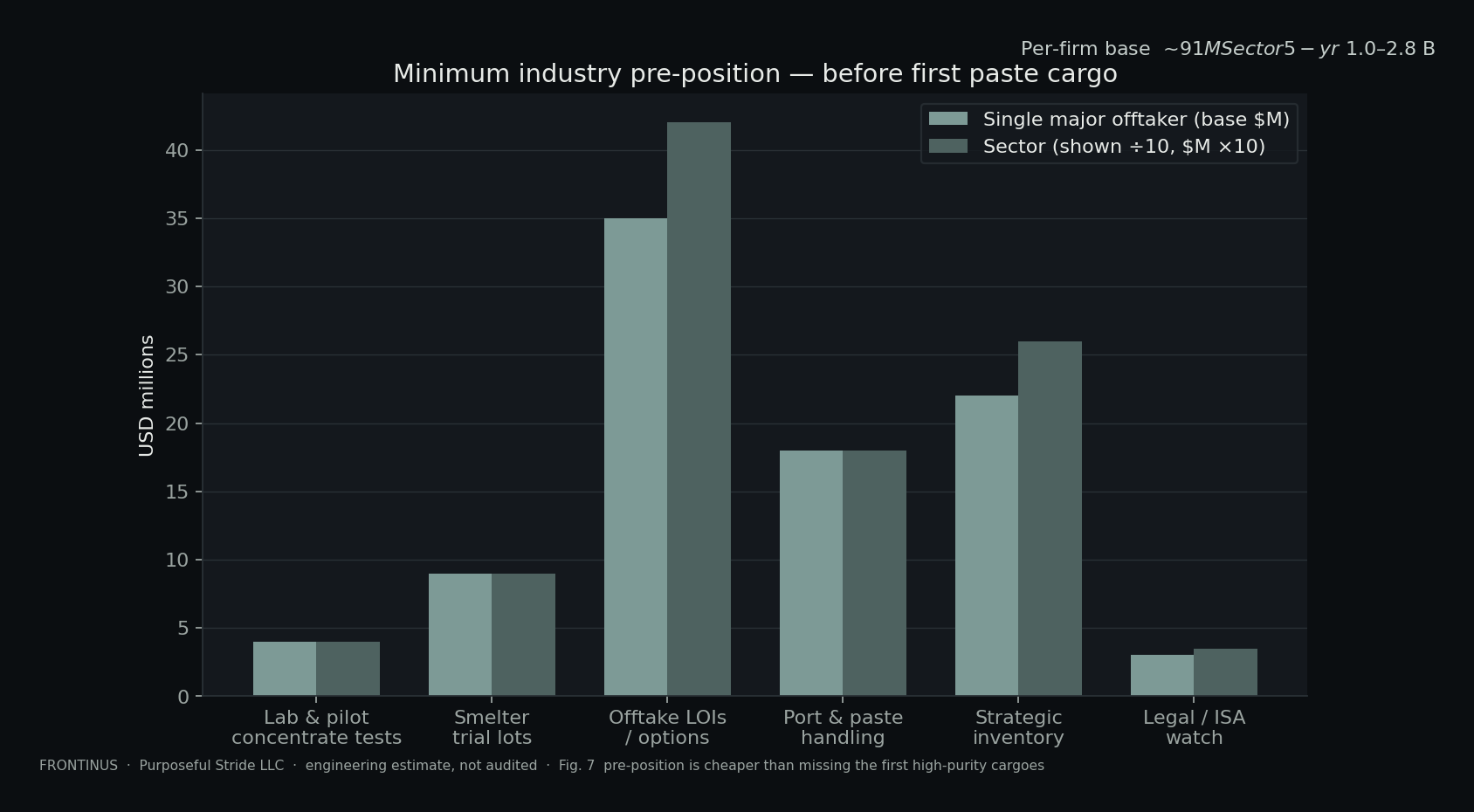

Minimum offtaker pre-position (base)
Per major custom smelter / trader: about $91 M. Sector-wide over five years: roughly $1.0–2.8 B if copper, zinc, precious and cobalt circuits all move. That is inventory, trials and options — not building a ridge field.
- Lab & pilot concentrate tests$4 M
- Smelter trial lots$9 M
- Offtake LOIs / options$35 M
- Port & paste handling$18 M
- Strategic inventory$22 M
- Legal / ISA watch$3 M
